Meta $250B+ Louisiana AI data center expansion
TECH

Meta $250B+ Louisiana AI data center expansion

38+
Signals

Strategic Overview

  • 01.
    On July 13, 2026, Meta said it will invest roughly $40 billion more in its Hyperion data center in Richland Parish, Louisiana, more than doubling planned capacity to 5 gigawatts.
  • 02.
    Planned investment in the site rises to as much as $50 billion, and Meta's total expected spend including computing chips now surpasses $250 billion.
  • 03.
    Meta agreed to pay for all 10 new Entergy power plants and to fund 2.5 gigawatts of new renewable energy, and pledged more than $1 billion for local roads, water and wastewater systems.
  • 04.
    Louisiana granted Meta roughly $3.3 billion in sales-tax exemptions running 20 years, with an option to renew for 10 more, to attract the project.

Deep Analysis

The 20% Stake That Lets Meta Walk Away

Meta's headline number - more than $250 billion for a single campus [1]- hides how little of the physical site Meta actually owns. Under a joint venture formed in October 2025, the private-credit firm Blue Owl Capital holds roughly 80 percent of the Hyperion campus through a special-purpose vehicle nicknamed Beignet, financed by about $27 billion in bonds [2]. Meta keeps only a 20 percent direct stake and leases the buildings back in four-year terms [2].

The structure does two things at once. It keeps tens of billions in construction debt off Meta's own balance sheet, and it gives Meta an exit. Because the leases renew every four years, Meta can in principle decline to renew and step away, while the power plants and transmission lines built specifically to serve the campus are designed to run for decades. Consumer advocates call the short lease an escape hatch, warning that the long-lived infrastructure could outlast Meta's commitment to pay for it [3].

Who Pays When the Servers Go Dark

Feeding a campus that will draw 5 gigawatts [4]requires an entire power system. Entergy Louisiana is building as many as 10 new plants, most of them natural gas, plus 240 miles of 500-kilovolt transmission line [5]. Meta has agreed to pay for the plants and to fund 2.5 gigawatts of new renewables [5], but that promise is only as durable as Meta's lease.

That is the crux of the ratepayer concern. Entergy serves roughly 1.1 million customers, and if Meta exits early the cost of gas plants sized for a single tenant could fall on ordinary households [6]. Paul Arbaje of the Union of Concerned Scientists notes the facility will consume about three times the annual electricity of the entire city of New Orleans [6]. The Louisiana Public Service Commission approved the fossil-fuel buildout and then declined to open a probe into the financing, a decision that alarmed groups including Earthjustice and the Alliance for Affordable Energy [3].

$3.3 Billion in Breaks, 1,000 Permanent Jobs

Louisiana granted Meta roughly $3.3 billion in sales-tax exemptions on data-center equipment and construction, running 20 years with an option to renew for another 10 - among the most generous data-center deals in the country [7]. To land a project of this scale, the state also fast-tracked approvals for the power plants that will feed it [4].

The return, in permanent employment, is modest. Once both phases finish around 2036, the site is expected to support roughly 1,000 permanent jobs against a construction peak of about 7,500 [5]. That gap - hundreds of billions in capital and a workforce that shrinks sharply when the building stops - is the sharpest point of criticism, both locally and online. Kasia Tarczynska of Good Jobs First called them wasteful subsidies for an industry that is growing very quickly and does not need public support [7].

Boomtown or Ghost Town

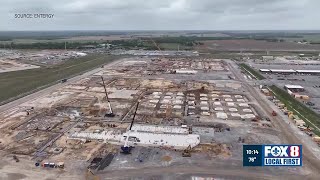

Richland Parish is home to about 20,000 people in one of the poorest regions of the country, and it is now absorbing thousands of construction workers and billions in spending [5]. The upside is concrete: since ground broke in 2024, Louisiana businesses have won more than $1.6 billion in contracts, and increased tax revenue funded teacher bonuses of up to $50,000 [6]. For a parish that size, that money is transformative.

But the same residents describe rents climbing steeply, displacement, constant dump-truck traffic, and strain on a parish water system that state regulators graded F in 2022 [6]. Online, the reaction has skewed skeptical rather than celebratory: technology and finance communities have fixated on the gap between the subsidies and the permanent jobs and on whether ever-larger AI campuses actually pencil out, while community discussion has also raised conflict-of-interest questions around local officials tied to nearby land deals. The prevailing sentiment frames the project less as a clean economic win than as a wealthy company externalizing its costs onto a place with little leverage to say no.

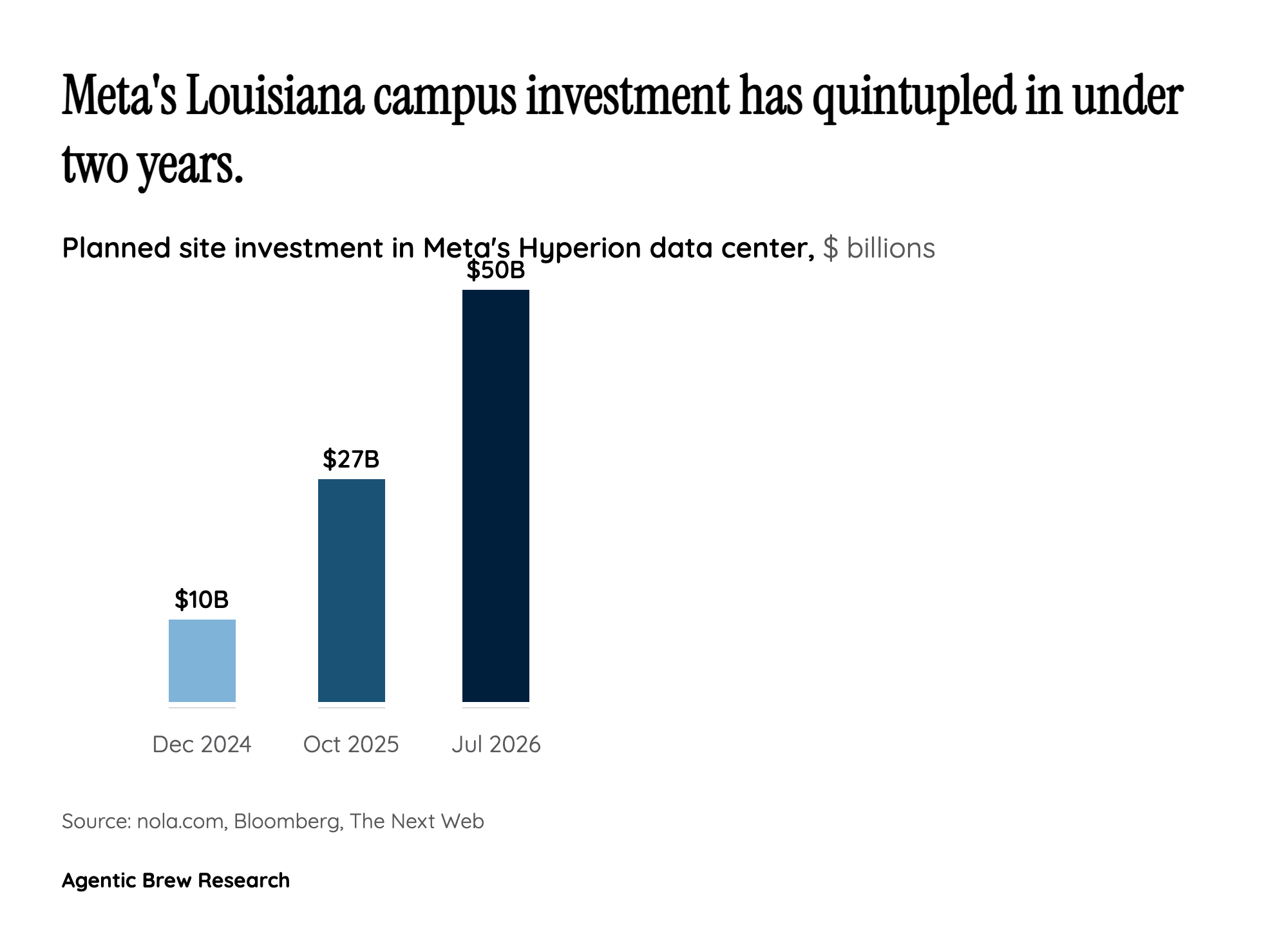

By The Numbers: A Fivefold Escalation

By The Numbers: A Fivefold Escalation
Meta's planned site investment in the Hyperion data center rose from $10 billion in late 2024 to $50 billion by mid-2026.

In under two years, Hyperion has grown from a $10 billion project into a $50 billion campus targeting 5 gigawatts, with Meta's total expected spend - including roughly $200 billion in chips - now exceeding $250 billion [1]. The physical footprint spans more than 3,200 acres, over four times the size of Central Park [5].

The escalation is not an outlier so much as a marker of where frontier AI is heading. Training the largest models now demands gigawatt-class superclusters, and the economics of that race are what turned a modest regional project into one of the largest private construction efforts in the country - and pulled a rural parish into the center of it.

Historical Context

2024-12
Hyperion was first announced as a roughly $10 billion project as construction began, internally codenamed Project Sucre.
2025-07-14
Zuckerberg publicly said Hyperion would scale to 5 gigawatts over several years, drawing major media attention.
2025-10
Meta formed a joint venture with Blue Owl-managed funds to finance and build the campus, with Blue Owl taking an 80 percent stake and targeting up to $27 billion in development costs.
2026-07-13
Meta announced the roughly $40 billion expansion to 5 gigawatts and $50 billion in site investment, pushing total expected spend past $250 billion.

Power Map

Key Players
Subject

Meta $250B+ Louisiana AI data center expansion

ME

Meta Platforms

Anchor tenant and operator of the campus, holding roughly a 20 percent direct stake and leasing the facility. Its capital decisions set the pace and scale of the entire buildout, and its commitments to fund power plants and local infrastructure shape the terms for everyone else.

BL

Blue Owl Capital

Private-credit firm that owns about 80 percent of the project through a special-purpose vehicle nicknamed Beignet, funded by roughly $27 billion in bonds. Meta leases the site back in four-year terms, a structure critics say lets Meta exit early.

EN

Entergy Louisiana

The utility building the power and transmission infrastructure, including as many as 10 new plants and 240 miles of 500-kilovolt line. Its roughly 1.1 million ratepayers are potentially exposed to the cost if the arrangement unwinds.

ST

State of Louisiana and Gov. Jeff Landry

Provided roughly $3.3 billion in sales-tax exemptions and fast-tracked power-plant approvals to land the project, and points to the investment as a signature economic win for the state.

LO

Louisiana Public Service Commission

The regulator that approved the fossil-fuel power buildout and then declined to open a probe into Meta's financing structure, a decision consumer groups say leaves the public interest unprotected.

RI

Richland Parish residents

A divided community of about 20,000 people. Some benefit from contracts, jobs and teacher bonuses, while others face rising rents, displacement, traffic and strained water and power systems.

Fact Check

7 cited
  1. [1] Meta's Louisiana Data Center to Surpass $250 Billion Price Tag
  2. [2] Meta's $200 billion Hyperion data center in Louisiana
  3. [3] Consumer Groups Alarmed as Louisiana PSC Declines to Take Up Probe Into Meta Risky Financing Deal
  4. [4] Meta expands data center campus in Richland Parish, Louisiana to 5GW, will invest $50bn
  5. [5] Meta's Louisiana data center investment to reach $50 billion, aided by generous tax incentives
  6. [6] Meta AI data center in Richland Parish, Louisiana, raises energy cost concerns
  7. [7] Meta's $10 billion Louisiana data center is getting $3.3 billion in tax breaks

Source Articles

Top 5

THE SIGNAL.

Analysts

"Says the single facility will consume roughly three times the annual electricity of the entire city of New Orleans, and criticizes Meta for shielding itself from financial risk after regulators approved the fossil-fuel project."

Paul Arbaje
Energy Analyst, Union of Concerned Scientists

"Argues Meta's novel financing lets it walk away from the project earlier than reported, shifting the long-term cost of fossil-fuel infrastructure onto ratepayers, and says regulators have a responsibility to take a hard look."

Susan Stevens Miller
Senior Attorney, Earthjustice

"Says the financing deal is not in the public interest and that the only parties benefiting from it and the associated fossil-fuel buildout are Meta and Entergy Louisiana."

Alaina DiLaura
PSC Policy Coordinator, Alliance for Affordable Energy

"Calls the tax subsidies wasteful for a fast-growing industry that does not need public support, and questions whether state and local budgets actually come out ahead."

Kasia Tarczynska
Analyst, Good Jobs First
The Crowd

"Meta is expanding its planned Louisiana Hyperion data center from 2GW to 5GW, lifting expected investment from $27B to $50B+ $META: https://t.co/i6cdbi3gIi"

@@TheTranscript_31

"TECH: META FUNDING SEVEN NEW GAS PLANTS TO POWER ITS LARGEST DATA CENTER @Meta is paying for the construction of seven new natural gas plants through Entergy Louisiana to power its Hyperion data center in Richland Parish. The plants will generate 5.2 gigawatts, roughly five https://t.co/UCNvGMgJGf"

@@BSCNews17

"Mark Zuckerberg's desire to build the world's biggest AI facility has entangled his company deeply into Louisiana's politics, culture and economy. https://t.co/wV3lngMwyv"

@@BW6

"Meta's Louisiana Data Center to Surpass $250 Billion Price Tag"

@u/Boraximus2400
