Anthropic's $45B Nscale Deal for West Virginia AI Compute
TECH

Anthropic's $45B Nscale Deal for West Virginia AI Compute

32+
Signals

Strategic Overview

  • 01.
    Anthropic agreed to pay Nscale $45 billion over six years for about 460 megawatts of AI compute capacity at Nscale's Monarch Compute Campus in West Virginia, powered by Nvidia's Vera Rubin chip system.
  • 02.
    The capacity covers roughly one-third of Monarch's initial 1.35 gigawatt buildout and is not expected to come online until late 2027.
  • 03.
    The deal, first reported by Bloomberg, arrives as Anthropic prepares a planned October 2026 IPO after confidentially filing with the SEC in June at a targeted valuation above $2 trillion.
  • 04.
    Microsoft had signed a letter of intent for this same West Virginia site in March 2026 before walking away from the arrangement over the summer, freeing the capacity Anthropic then claimed.

Deep Analysis

Anthropic Inherited Microsoft's Leftover Capacity

In March 2026, Microsoft signed a letter of intent for the entirety of Nscale's planned Monarch Compute Campus in West Virginia - 1.35 gigawatts and roughly 430,000 Nvidia Vera Rubin GPUs[1]- only to walk away from that commitment sometime over the summer[1]. Anthropic has now stepped into the gap, agreeing to pay Nscale $45 billion over six years for approximately one-third of that same site: about 460 megawatts of power in the first of three planned buildings, running on Nvidia's six-chip Vera Rubin system[2][3].

The handoff matters as much for Nscale as it does for Anthropic. The contract is now the largest in Nscale's roughly $51 billion revenue backlog and reportedly anchors the UK infrastructure firm's own IPO, targeted for as soon as September 2026 at about a $3 billion raise under lead banks Goldman Sachs and JPMorgan[1]. Without a marquee replacement tenant after Microsoft's exit, Nscale would have been pitching public investors on a half-built campus with no signature customer - Anthropic's name solves that problem for Nscale just as directly as the capacity solves Anthropic's compute crunch.

Anthropic's Compute Bill Has Passed $150 Billion With No Revenue Backstop

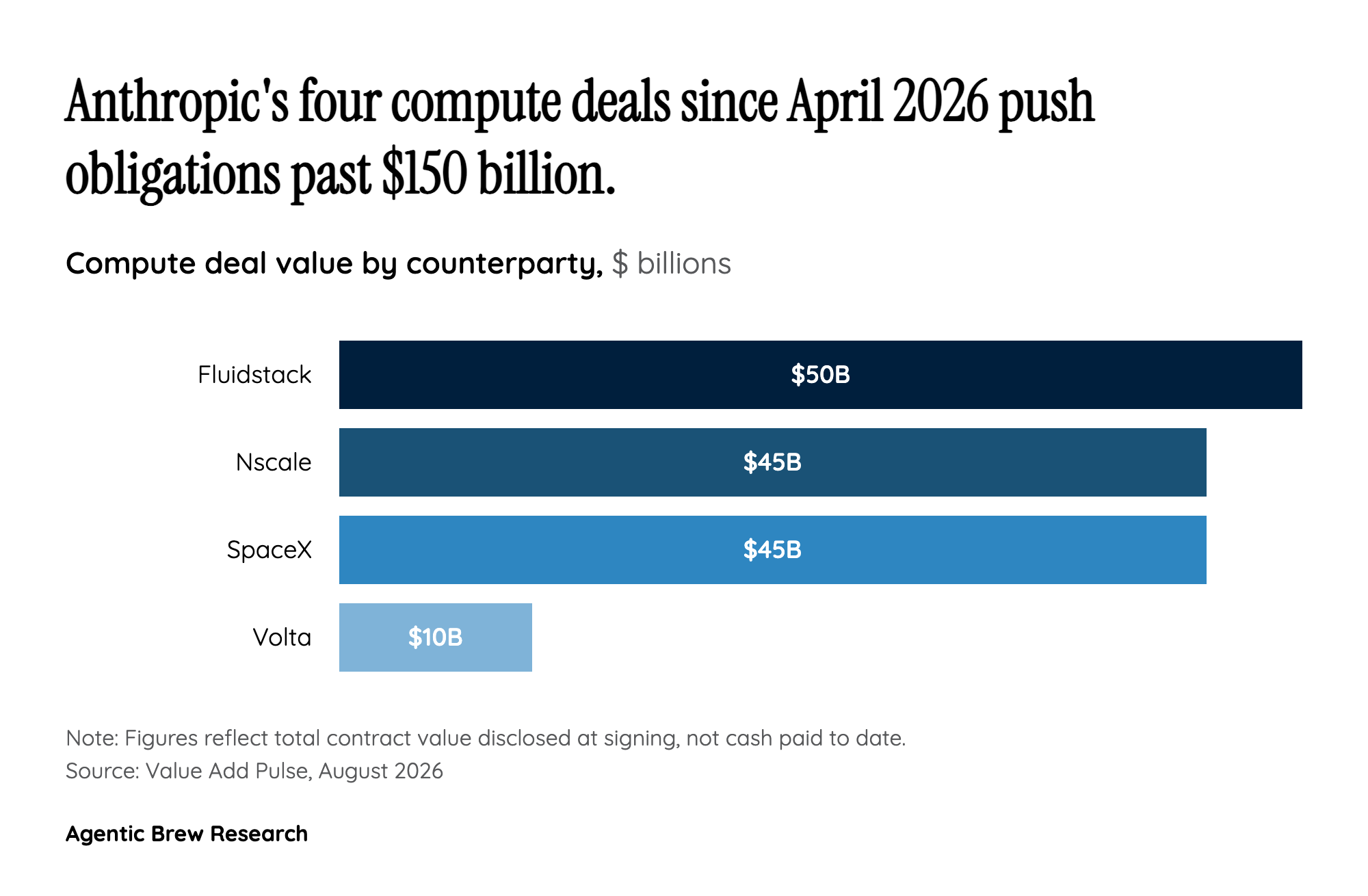

Anthropic's Compute Bill Has Passed $150 Billion With No Revenue Backstop
Anthropic's four compute deals since April 2026 push obligations past $150 billion.

The Nscale contract is Anthropic's fourth nine-figure-plus compute commitment announced in a matter of months, alongside deals with Fluidstack ($50 billion), SpaceX ($45 billion) and Volta ($10 billion) - together pushing Anthropic's forward compute obligations north of $150 billion[4]. Value Add Pulse analyst Trace Cohen has pointed to the structure of that spending as the real risk: none of it is contingent on revenue actually showing up at the pace the commitments assume[4].

Anthropic has framed the buying spree as a response to its own success. The company said earlier in 2026 that surging Claude demand was causing "inevitable strain" on infrastructure, hurting reliability and performance during peak hours[5], a strain that set off a run of deals with AMD, Amazon, Google, Broadcom, SpaceX, Volta and now Nscale, widely read as an effort to keep pace with rivals, chiefly OpenAI[6]. All of it lands as Anthropic prepares to open its books to public markets, having confidentially filed for an IPO in June 2026 and reportedly targeting an October listing at a valuation above $2 trillion[7].

The Capacity Won't Exist Until Late 2027 - This Is a Bet on the Future, Not a Fix for Today

Unlike a typical cloud rental, the Monarch facility's Vera Rubin chip systems are not due to come online until late 2027[3], meaning the deal does nothing to relieve the reliability strain Anthropic says it is experiencing right now. It is a six-year reservation on a data center building that has yet to be completed, running chips Nvidia has not yet shipped.

That gap between announcement and delivery is exactly what online reaction has zeroed in on. Discussion across tech and finance-focused communities has been broadly skeptical, treating the $45 billion figure less as cash changing hands today than as a take-or-pay style commitment - a promise to pay if the capacity gets used, not a bill already due. Some of that skepticism extends to feasibility doubts about whether a not-yet-built facility running not-yet-manufactured chips can plausibly solve the near-term capacity constraints Anthropic says it faces, while a smaller, more analytical thread has focused instead on the deal's read-through for Nvidia as the chip supplier that benefits regardless of how the compute ultimately gets used.

West Virginia Cashes In on a Bet It Didn't Place

For Mason County, the numbers are concrete even if Anthropic's compute math is not: Nscale's Monarch buildout is projected to create 6,000 construction jobs over two years and 700 permanent Phase 1 positions, plus an estimated $105 million in tax revenue split between schools, county government and public safety[2]. Nscale has also donated $500,000 to Mason County schools for worker training tied to the project.

Governor Patrick Morrisey called the deal "an extraordinary vote of confidence" in the state's economic development strategy, while Monarch site manager Jason Bechtle emphasized the "high-skilled STEM trade jobs" Phase One construction will bring to the area[2]. The regional payoff is real and immediate in a way the compute deal itself is not - it doesn't depend on Anthropic's revenue catching up to its commitments, only on the buildings getting built.

The Overcapacity Risk Nobody's Pricing In

The deal materially de-risks Nscale's IPO pitch, giving its bankers a large, named, long-duration revenue commitment from a creditworthy counterparty to lead with in the prospectus[8]. But the same concentration cuts both ways: Nscale's growth story now leans heavily on a handful of oversized tenants, and if Anthropic's compute expansion outpaces real-world Claude adoption, cheaper open-source rivals or simple infrastructure overcapacity could erode returns on both companies' capital commitments[8].

That is the tension sitting underneath every one of Anthropic's four mega-deals this year: each new contract buys insurance against a demand curve that has not been tested in public markets. The Nscale agreement does not resolve that tension - it just extends the timeline on which investors will find out whether the bet was right.

Historical Context

2026-03
Microsoft signed a letter of intent for 1.35 gigawatts and roughly 430,000 Vera Rubin GPUs at the same Monarch West Virginia campus.
2026-04
Anthropic expanded compute partnerships, including an additional 5 gigawatts with Amazon and expansions with Google and Broadcom.
2026-05
Anthropic signed a compute deal with SpaceX reported at roughly $1.25 billion per month.
2026-06
Anthropic submitted a confidential IPO filing to the SEC.
2026
Microsoft walked away from its 1.35 gigawatt Monarch campus commitment earlier in the summer, freeing the capacity Anthropic later claimed.
2026-07
Anthropic signed a $5 billion compute deal with AMD.
2026-08
Anthropic signed a $10 billion, six-year compute deal with Volta for a Norwegian data center.
2026-08-26
Bloomberg first reported the $45 billion, six-year Anthropic-Nscale deal for 460MW at the West Virginia Monarch campus.

Power Map

Key Players
Subject

Anthropic's $45B Nscale Deal for West Virginia AI Compute

AN

Anthropic

Renting compute to relieve reliability strain from rising Claude demand ahead of its IPO; now carries over $150 billion in total compute commitments across four providers (Fluidstack, Nscale, SpaceX, Volta).

NS

Nscale

UK-founded neocloud building the Monarch Compute Campus; the Anthropic deal is the largest contract in its roughly $51 billion backlog and is expected to anchor its planned September 2026 IPO.

MI

Microsoft

Previously held a March 2026 letter of intent for the full 1.35GW / roughly 430,000 Vera Rubin GPUs at this same site but walked away over the summer, freeing the capacity Anthropic later claimed.

NV

Nvidia

Supplies the six-chip Vera Rubin system that will power the facility once it comes online in late 2027, benefiting from the deal regardless of how the underlying compute is ultimately used.

MA

Mason County, West Virginia / Gov. Patrick Morrisey

Benefiting from projected 6,000 construction jobs, 700 permanent Phase 1 jobs, and roughly $105 million in tax revenue, plus a $500,000 Nscale donation to local schools for worker training.

Fact Check

8 cited
  1. [1] Anthropic Reportedly Behind Nscale's $45bn AI Compute Contract
  2. [2] Reports: Nscale Cuts Deal With Anthropic For Data Center Space At Monarch Compute Campus
  3. [3] Anthropic Signs $45B Compute Deal With British Infrastructure Firm Nscale
  4. [4] Anthropic Nscale $45 Billion Cloud Deal
  5. [5] Anthropic and Nscale Strike $45 Billion Cloud Deal, Sources Say
  6. [6] Anthropic Continues Compute-Gobbling Streak in $45 Billion Deal With Nscale
  7. [7] Anthropic Signs $45 Billion Cloud Deal
  8. [8] Anthropic Nscale $45 Billion AI Infrastructure Deal

Source Articles

Top 5

THE SIGNAL.

Analysts

Warns that Anthropic's four stacked compute deals push forward obligations past $150 billion with none of it contingent on revenue actually materializing at the assumed pace, a key IPO risk.

Trace Cohen
Value Add Pulse (VC/analyst commentary)

Frames the AI buildout as "the fourth industrial revolution," justifying the scale of the infrastructure investment behind deals like this one.

Josh Payne
Founder, Nscale

Calls the deal "an extraordinary vote of confidence" in the state's economic development strategy, treating the local jobs and tax revenue as validation independent of how Anthropic's compute bet plays out.

Gov. Patrick Morrisey
Governor, West Virginia

Emphasizes the near-term local job creation from Phase One construction, citing 700 high-skilled STEM trade jobs becoming available on-site.

Jason Bechtle
Site Manager, Monarch Compute Campus
The Crowd

Anthropic to pay Nscale $45B for AI Compute >Nscale's off-grid Monarch compute campus to be built with NVDA chips; initial deal for 2GW of CAT turbines >$45B covers 460MW out of Phase 1 planned 1.3GW >Phase 2 up to 8GW >MSFT had signed LOI but backed out earlier in the summer

@@matthew_sigel233

Anthropic ❤️ Nscale Anthropic has agreed to pay Nscale $45B over six years to rent about 460MW of power, using Nvidia's Vera Rubin chips as per Bloomberg. More compute 👀

@@testingcatalog441

Anthropic agrees $45bn AI data centre deal with UK start-up Nscale

@@FT318

Anthropic to Pay Nscale $45 Billion for AI Computing Power

@u/ksjdragon48
Broadcast
AI News Briefing - August 27, 2026 #ai #ainews #latestainews

AI News Briefing - August 27, 2026 #ai #ainews #latestainews

Anthropic's $45B AI Bet: Data Centers, IT Careers & Power Grids

Anthropic's $45B AI Bet: Data Centers, IT Careers & Power Grids

Nvidia's $12.9B Buy, Anthropic's $45B Deal & Moonshot's Play..

Nvidia's $12.9B Buy, Anthropic's $45B Deal & Moonshot's Play..
